Install from the Marketplace

If you have not installed WorkHub yet, grab it from the monday.com Marketplace. Once installed, the app is available as both a Board View and a Workspace View across your account.

Workspace View vs Board View

WorkHub offers two ways to access its features, each suited to a different workflow.

Workspace View

Workspace View is a full-screen application accessible from the monday.com left sidebar. It contains seven modules:

Workspace View is the main way to use WorkHub. Use it for everything that isn't scoped to a single board: timesheets, leave management, reports, settings (boards, capacity schemes, holidays, permissions), cross-board resource planning in the Scheduler, and the My Account personal view. Board View is a lightweight companion for planning and logging time on a single board without leaving it — but timesheet submission, leave requests beyond the scheduler cell menu, all reports, and all admin settings live only in Workspace View.

Opening Workspace View

  1. In the monday.com left sidebar, open the Workspaces panel.
  2. Select the workspace you want to work in (for example, Main workspace).
  3. Expand Workspace apps.
  4. Click the WorkHub: Plan, Track & Report entry to open Workspace View.

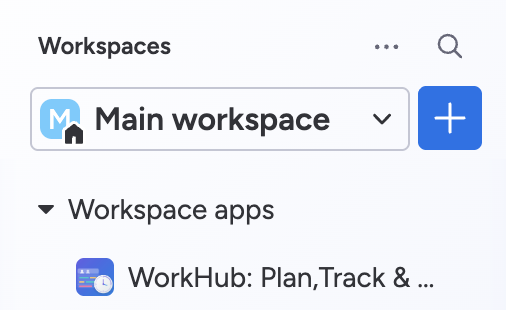

monday.com Workspaces panel expanded to show Workspace apps with WorkHub: Plan, Track & Report listed as an app entry
Don't see WorkHub under Workspace apps?

The WorkHub app hasn't been added to this workspace yet. Install it once from the monday.com Marketplace — after that, it appears under Workspace apps in every workspace on the account.

WorkHub Workspace View showing the resource scheduler with sidebar navigation for all seven modules

Board View

Board View is added as a view tab on a single monday.com board. It provides two tabs:

Use Board View when you want a focused scheduler for one project board without leaving the board context.

Both tabs support the same cell quick actions as Workspace View — click an empty cell on any row to create an item, log time, or request leave without leaving the scheduler.

Adding Board View to a board

  1. Open the monday.com board you want to schedule from.
  2. Click the + button in the row of view tabs next to Main table (or whichever views your board already has).
  3. In the Board views menu that opens, hover over Apps.
  4. Under Installed, pick the WorkHub entry published by Reinwok — the hover preview confirms "Resource planning, timesheets, capacity & leave management by Reinwok".
  5. The new view opens as a tab on your board with the Resource Planning and Worklog tabs, scoped to this board's items.

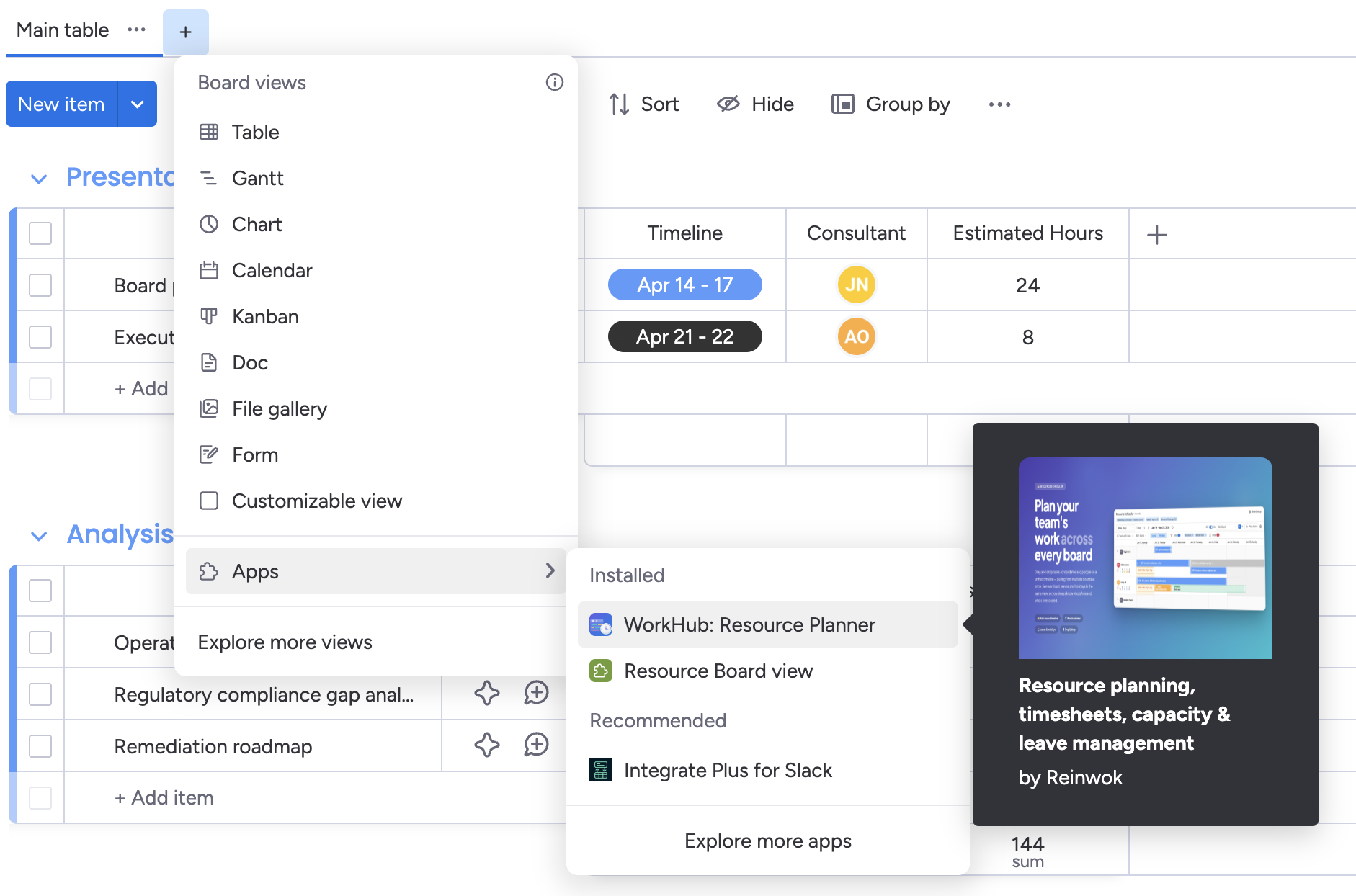

monday.com Board views menu with the Apps submenu open, showing WorkHub: Resource Planner under Installed apps by Reinwok

The first time you add Board View to a board, the field-mapping wizard launches automatically to pick the Item Level and map your Timeline and Assignees columns. The mapping is saved per board and shared across all users who add the view to that board.

App not listed under Installed?

If you don't see the WorkHub app under Apps → Installed, it hasn't been installed on your account yet. Install it once from the monday.com Marketplace; after that, every board on the account can add the Board View from the + menu.

Items and Subitems

Monday.com boards have two levels of items that WorkHub can work with:

During board setup (or in the settings sidebar), you choose the Item Level setting:

When subitems are enabled, field mapping is configured separately for the subitems board since it has its own column structure — see Field Mapping below.

Create items directly from the scheduler

You can create new items (main or subitem, depending on the board's Item Level) without leaving the scheduler — click an empty cell on someone's row to open the quick actions menu. The same menu also lets you log time and request leave for the selected date range.

Field Mapping

Before the scheduler can display your board data, it needs to know which monday.com columns correspond to which concepts. This is called field mapping. Each board has its own mapping configuration.

Monday.com board showing configured columns: Assignee (People), Timeline, Estimated Hours (Numbers), and Estimated Hours Per Day (Numbers) on main items, with Timeline and Assignee mapped on subitems

The six available field mappings are:

Field Column Type Required? Purpose
Assignee People Yes Determines who is assigned to each item. The scheduler organizes tasks by person, so this field is essential.
Timeline Timeline Yes Provides start and end dates. The scheduler positions items horizontally by date range.
Original Estimate Numbers No Total estimated hours for the entire task duration. The scheduler divides this across working days in the timeline range for workload calculation.
Hours Per Day Numbers No Estimated hours per working day. An alternative to Original Estimate for teams that estimate in daily effort rather than totals.
Status Status No Enables status-based card coloring and lets you filter completed items from the scheduler view.
Color Color Picker No Provides custom card coloring when the color schema is set to "picker" mode.

Required fields explained

Assignee and Timeline are the only required fields because they answer the two fundamental scheduling questions: who is doing the work and when. Without an Assignee column mapped, the scheduler cannot create rows for team members. Without a Timeline column, items have no date range and cannot be placed on the calendar.

Original Estimate vs Hours Per Day

These two fields control how workload is calculated. You can map one, the other, or both — but the scheduler needs at least one for workload indicators to reflect real planned effort. If neither is mapped, items still appear on the scheduler (Assignee and Timeline are the only requirements), but each item contributes 0 hours to the workload indicator.

Both formulas use the assignee's working days, not raw calendar days. A day counts as working only when all three of these are true:

Original Estimate

Use this when your team estimates total effort per task. The plugin divides the total by the number of working days in the item's timeline range and distributes the result evenly.

Example

A task has 16 hours in the Original Estimate column and a timeline of Monday to Thursday (4 working days, no holidays or leave). The plugin calculates 4 hours per day (16 ÷ 4) for workload purposes.

Same task, but the assignee is on approved leave on Wednesday. Wednesday is excluded from the working-day count, so the 16 hours are spread over the remaining 3 working days — about 5.33 hours per day on Mon, Tue, and Thu.

Hours Per Day

Use this when your team estimates daily effort instead of totals. The plugin uses the per-day value directly for each working day in the timeline — no division is needed. On non-working days (non-working days in the capacity scheme, holidays, or approved leave) the per-day value is skipped entirely, not added.

Example

A task has 3 hours/day in the Hours Per Day column and a timeline of Monday to Friday. With a standard Mon–Fri capacity scheme and no holidays, the plugin counts 3 hours each day, totaling 15 hours across the week.

Same task on an assignee with a 4-day week (Friday off): the plugin counts 3 hours on Mon–Thu and 0 on Friday, totaling 12 hours for the week.

When both are mapped

If both columns are mapped on the same board, Hours Per Day takes precedence per item. The Original Estimate column is used as a fallback only when the per-day value is missing, empty, zero, or negative for that specific item. This lets you mix the two approaches on the same board — leave Hours Per Day blank on items where you only know the total, and fill it in on items where you know the daily rhythm.

Which should I use?

Most teams use Original Estimate because it aligns with how estimates are typically given ("this task will take 20 hours"). Use Hours Per Day if your team plans in daily time blocks ("I'll spend 2 hours per day on this"). If you're unsure, map only Original Estimate — you can always add Hours Per Day later.

Other optional fields

Status enables two features: coloring task cards by their status label (e.g., "Working on it" = orange, "Done" = green) when using the Status color schema, and filtering completed items out of the scheduler view.

Color (Color Picker) is only needed if you want to assign custom colors to individual items. Most teams use the Status or Group color schema instead.

Subitems have separate field mapping

Subitems live on their own subitems board in monday.com. When you enable subitems, WorkHub shows a second mapping table for the subitems board, allowing you to map columns independently from the parent board. The example screenshot above shows the parent board with Assignee, Timeline, Estimated, and Estimated H/D mapped, while the subitems board has just Timeline and Assignee.

Board Setup & Configuration

Before the scheduler can show anything, WorkHub needs to know which boards to load and how each board's columns map to the scheduler's concepts. Two separate screens handle this:

Opening Workspace View without any boards

If you haven't mapped any boards yet, Workspace View still opens — the scheduler shows your team with holidays and existing leaves. You can request leave and log time in this state (Log time's item picker queries monday.com directly, so it doesn't need a configured board). To start planning or creating items and to use workload indicators, add a board via the board-selection screen below.

Selecting boards for the Workspace View scheduler

The first time you open Workspace View → Scheduler, you land on the board-selection screen. You can return to this screen any time via the Board setup button in the scheduler toolbar.

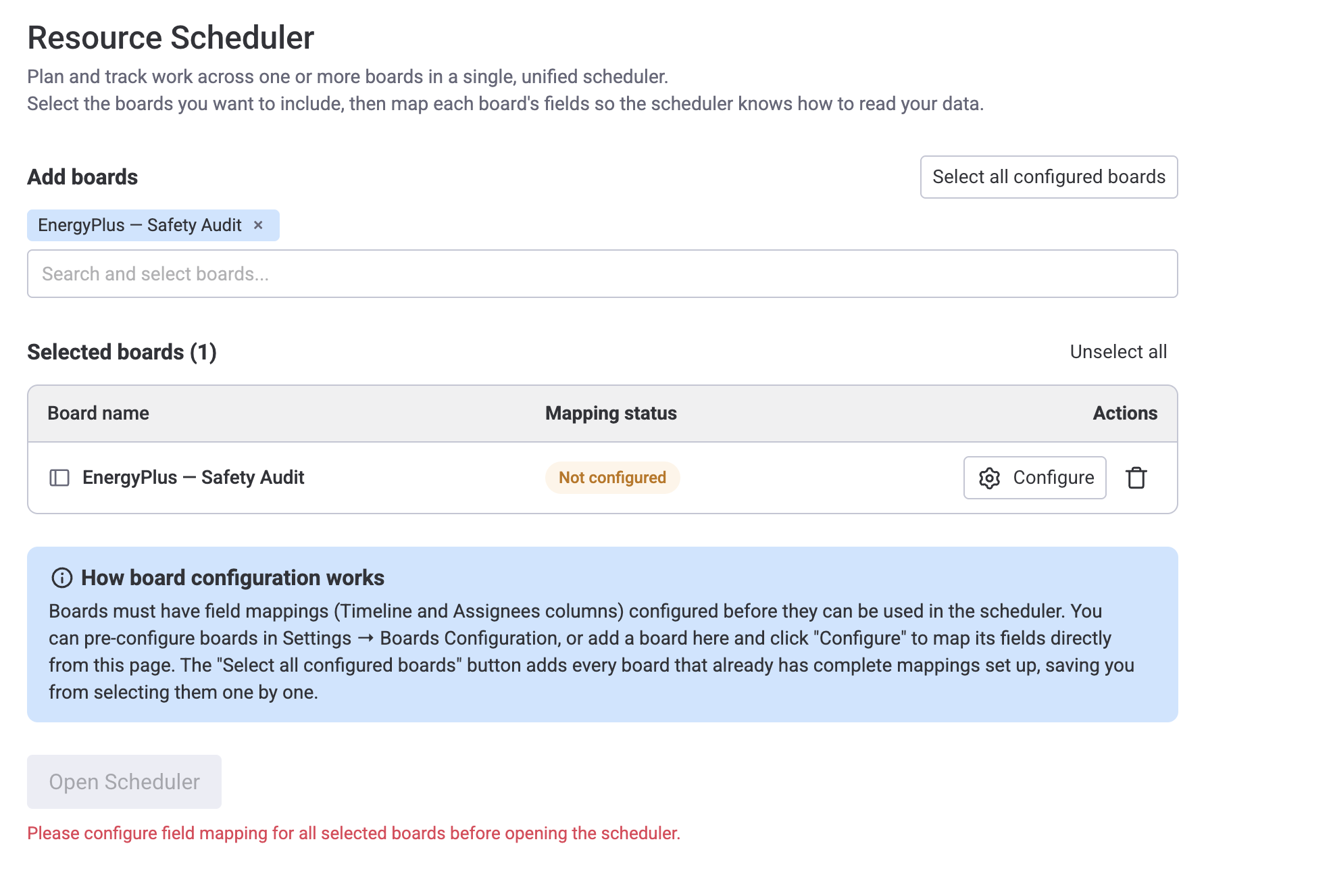

Resource Scheduler board-selection screen showing Add boards search, Select all configured boards button, Selected boards table with a Not configured board, How board configuration works info callout, and disabled Open Scheduler button

Two ways to add boards to your selection:

Each row in the Selected boards table shows:

The Open Scheduler button is disabled until every selected board is Configured — the red message "Please configure field mapping for all selected boards before opening the scheduler" tells you why. You can also click Open Scheduler with zero boards selected; a confirmation asks whether to continue, and confirming takes you into the scheduler showing only your team with their holidays and leaves (pending and approved) — useful for requesting leave or logging time before any boards have been mapped. Add a board later via Board setup to start planning items.

Selection is saved in your browser

Your list of selected boards is saved in the browser's local storage, so it is per device. Opening Workspace View in a different browser or on another computer starts with an empty selection. The boards' field mappings, by contrast, are saved server-side and shared across users and devices — once an admin maps a board, every user can add it from the board-selection screen without remapping.

Configuring a board's fields (field-mapping wizard)

When you configure a board for the first time — whether by clicking Configure on the board-selection screen, by adding the scheduler to a Board View, or by editing a board in Settings → Boards Configuration — the field-mapping wizard launches. It walks you through two steps:

  1. Item Level — choose whether to show Main items, Sub-items, or Both on the scheduler.
  2. Field Mapping — select which monday.com columns map to each field. The dropdowns only show compatible column types (e.g., only People columns appear for Assignee, only Timeline columns for Timeline).

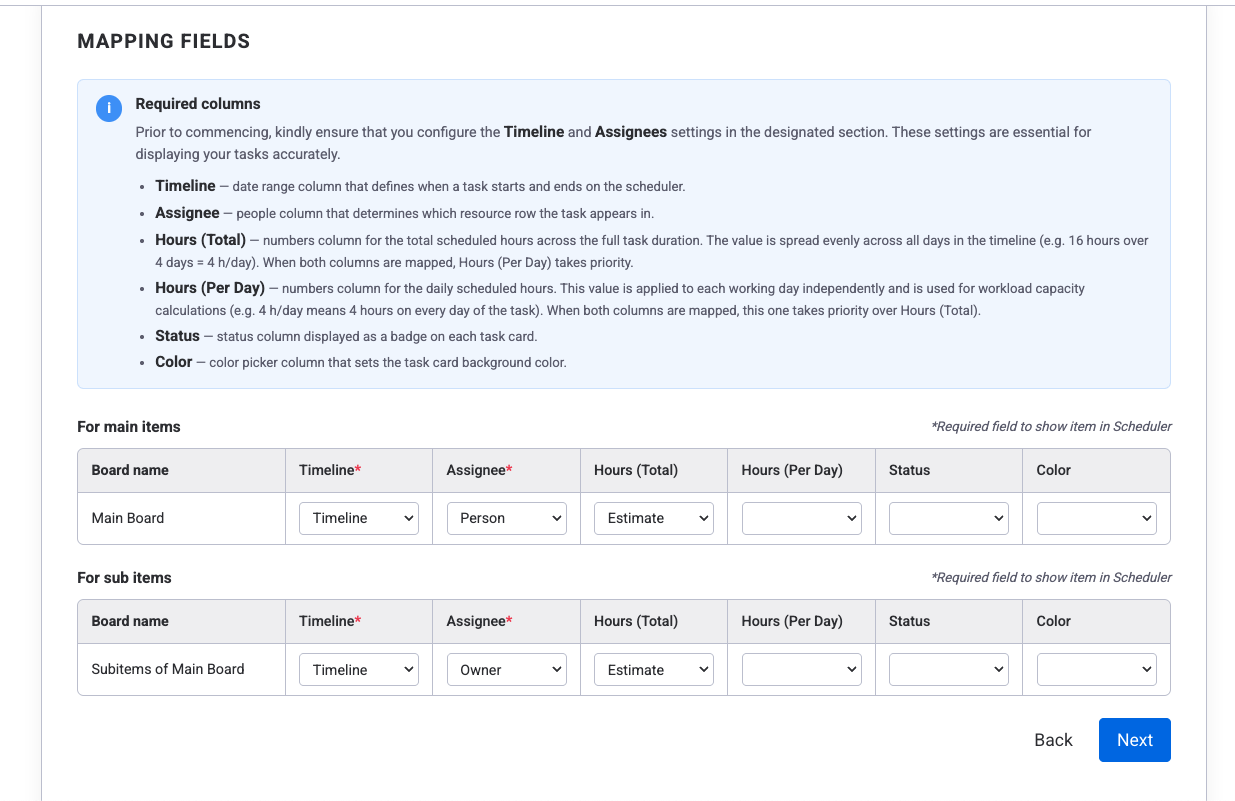

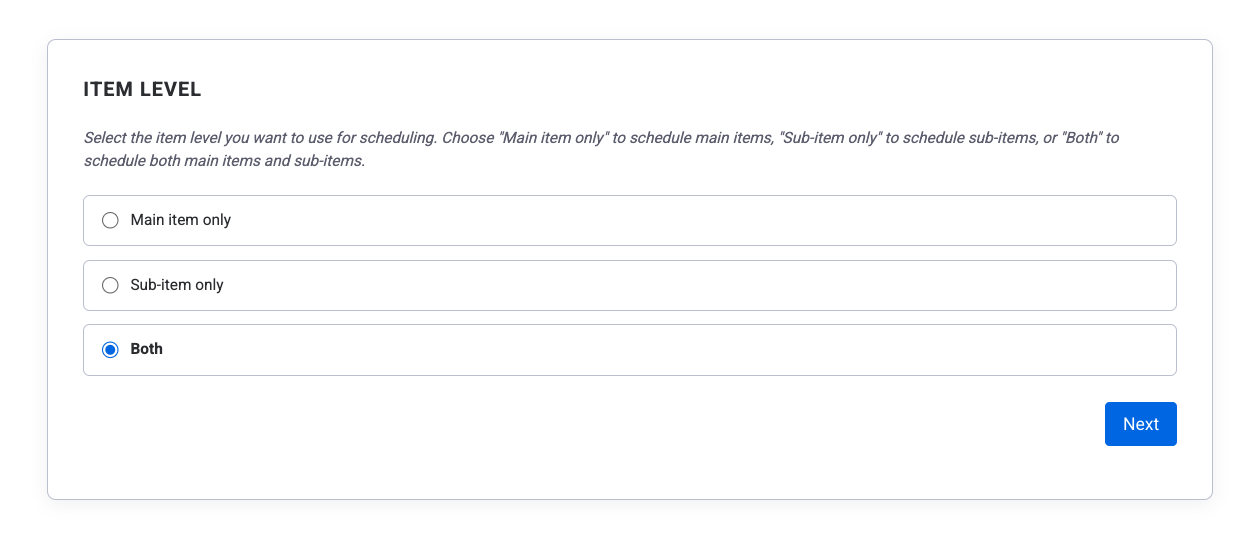

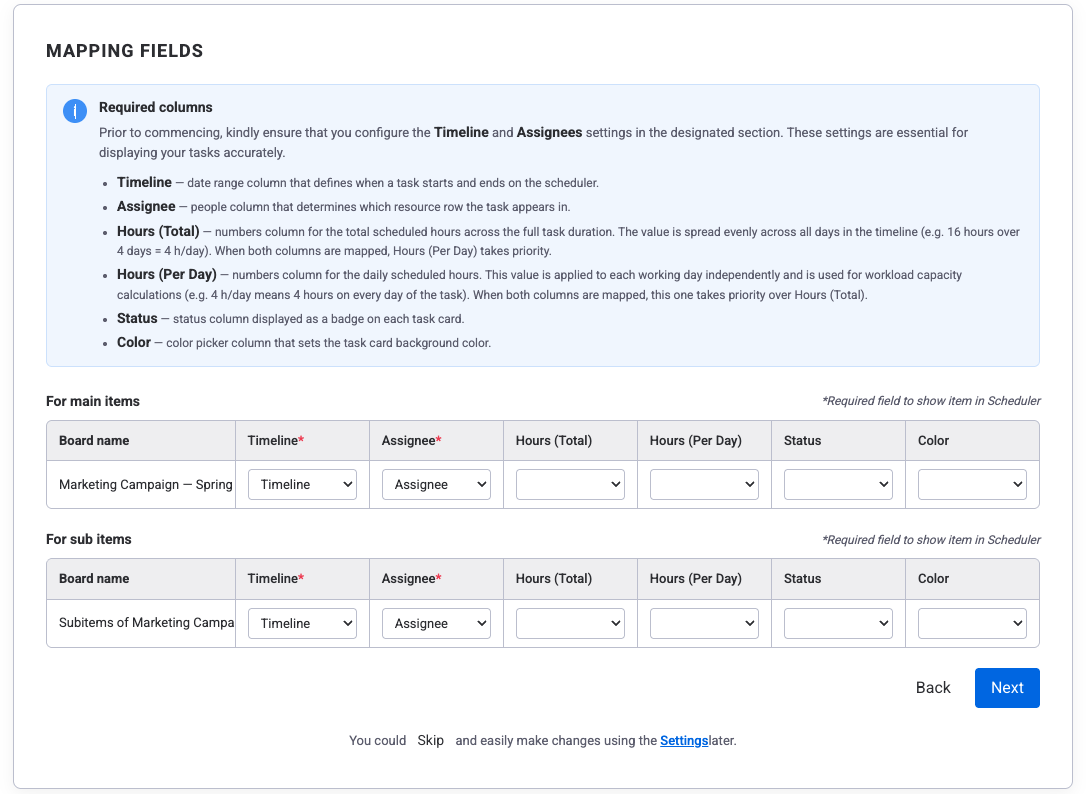

Board setup wizard step 1: Item Level selection — Main item only, Sub-item only, or Both Board setup wizard step 2: Mapping Fields showing Timeline, Assignee, Hours, Status, and Color column dropdowns for main items and subitems

You can return to the wizard at any time to reconfigure field mappings — either from the board-selection screen (Edit mapping) or from Settings → Boards Configuration. Changes apply to every user who uses that board on the scheduler.

For additional options beyond the wizard, open the scheduler for that board first — then click the settings icon in the top-right corner. This opens the board settings sidebar, which is only available while the scheduler is active and provides the same field mapping options plus display settings.

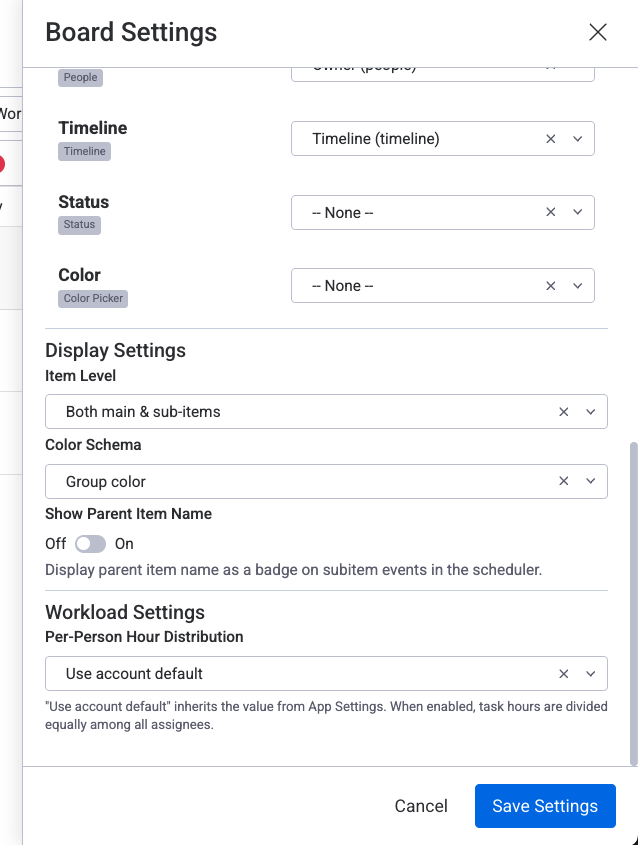

Display settings panel accessed via the settings icon, showing color schema, item height, and per-person distribution options
Display settings are only in the settings sidebar

Settings like color schema, item height, and per-person distribution are not available during the initial field-mapping wizard. Access them by clicking the settings icon in the top-right corner after the board is configured.

Scheduler Overview

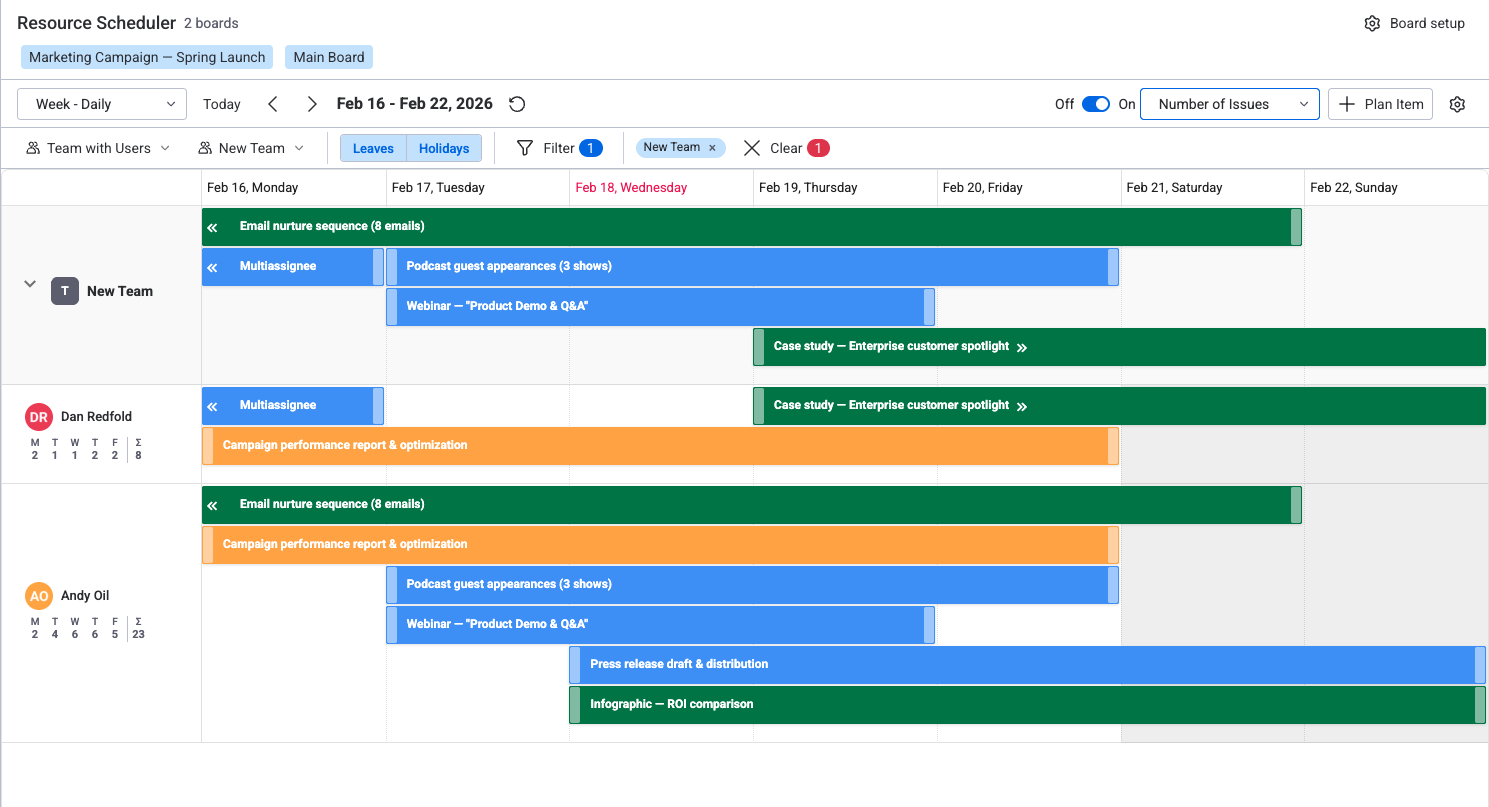

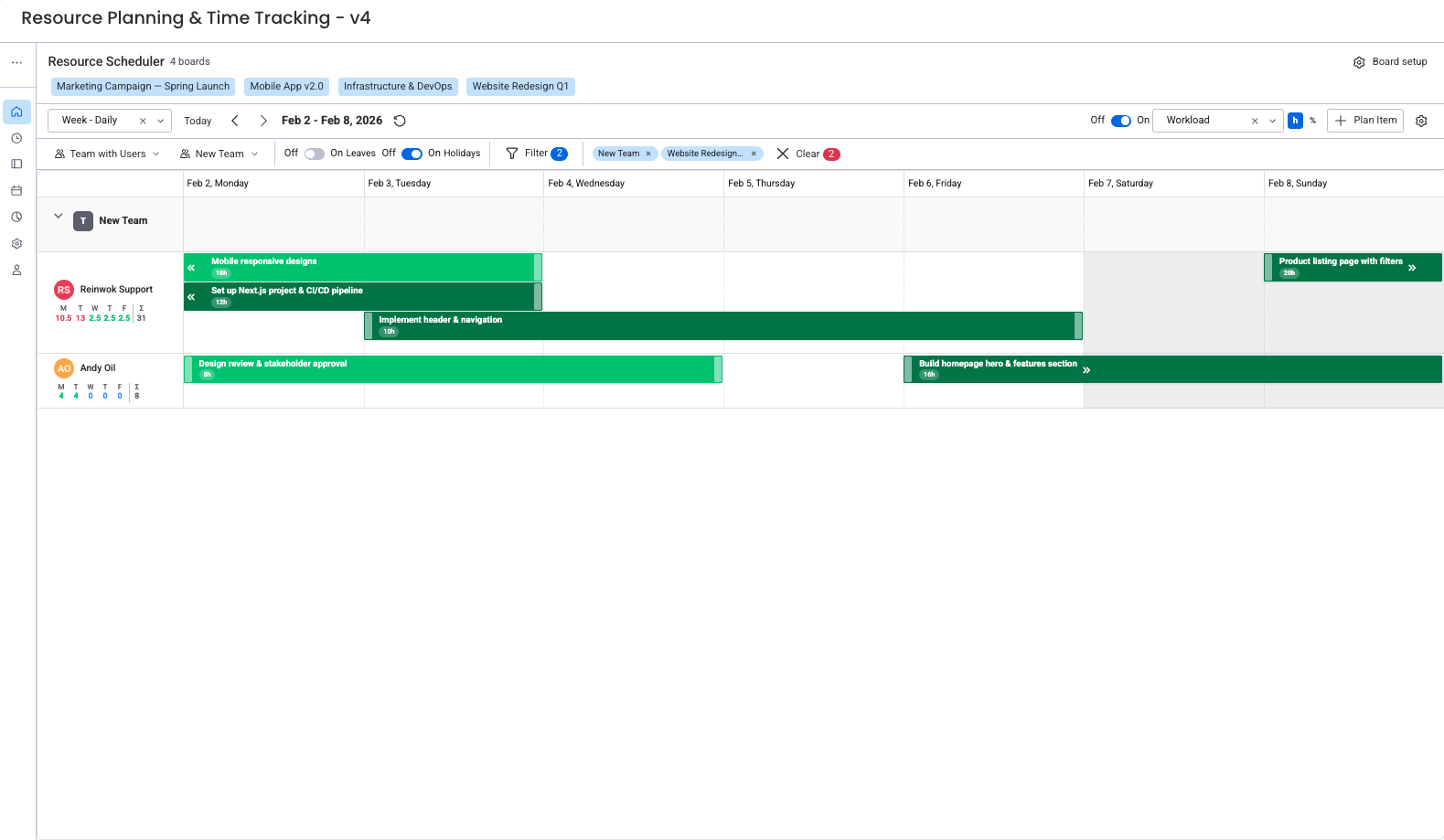

The resource scheduler is a Gantt-like timeline where each row represents a team member and task cards are positioned by their timeline dates.

View modes

Five zoom levels let you see the right time horizon:

Group-by modes

The scheduler toolbar lets you choose how rows are organized:

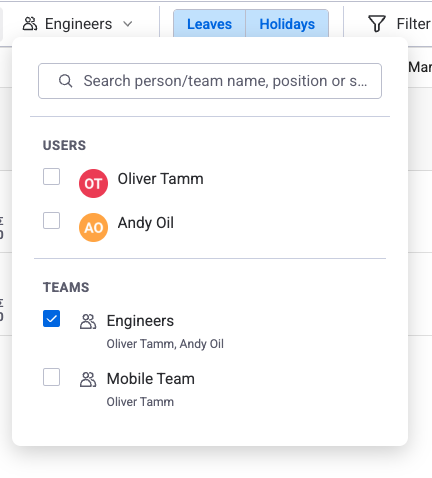

Group-by dropdown showing Users, Teams, and Teams with Users options Scheduler grouped by Teams showing team sections with member task cards

You can select multiple teams in the Team filter to display several teams side by side on the scheduler. This is useful for cross-team planning and comparing workload across departments.

Assigning items to teams

In monday.com, items can be assigned to a team (not just individual users). When an item is assigned to a team, it appears on the team's row in the scheduler. You can then drag the item from the team row to a specific user's row to reassign it to an individual. This lets managers assign work at the team level first and then distribute it to specific people during planning sessions.

You can also filter which users or teams are visible using the Assignee and Team filter dropdowns in the toolbar.

Leave & holiday display toggles

The toolbar includes Leaves and Holidays toggle buttons. When enabled, leave days (pending and approved) and holidays appear as colored blocks on the scheduler. Toggling them off hides the visual blocks for a cleaner view, but workload indicators always account for approved leave and holidays regardless of the toggle state — this is purely a visual change, not a calculation change.

Scheduler toolbar showing Leaves and Holidays toggle buttons

Drag-and-drop

Drag a task card horizontally to reschedule it to different dates, or vertically to reassign it to another team member. Changes sync to monday.com in real time.

Capacity & Workload Basics

Each person's daily capacity is the number of hours they're available to work. Workload is the sum of planned hours (from item estimates) against that capacity, shown as a colored indicator on each day: green when under capacity, orange when near it, red when over.

Three things reduce a person's capacity for a given day:

When per-person distribution is enabled in display settings, tasks assigned to multiple people split their hours equally among assignees. For example, a 10-hour task with two assignees counts as 5 hours per person.

Workload indicator modes

The workload overlay offers five indicator modes, each showing a different perspective on your team's load. The default Worklog + Workload mode combines actual logged worklogs (for past days) with remaining estimates (for future days), giving you the most accurate real-time view. See Workload Management → Indicator Modes for a full explanation of all modes.

What's Next

Now that you understand the core concepts, explore the features in detail:

Need help?

Start a live chat or email support@reinwok.com.
