Real-Time Workload Tracking

Color-coded capacity indicators per person per day. Spot overload and balance work across your team.

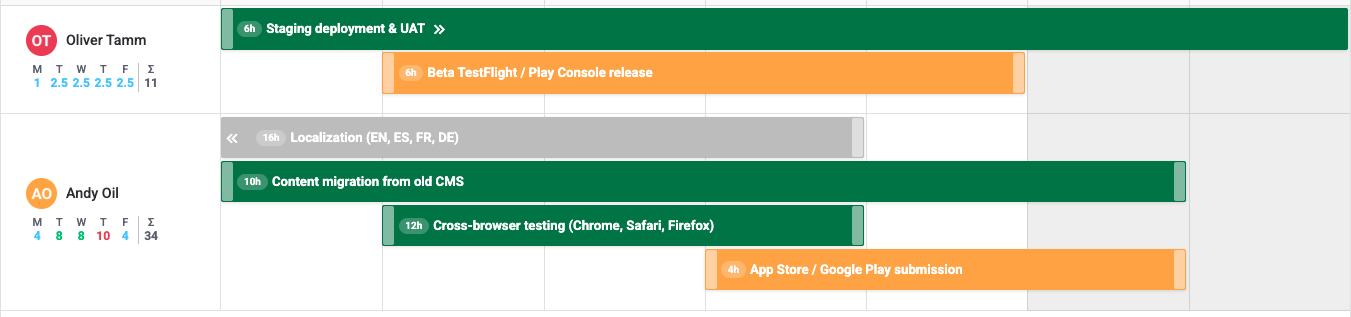

Workload indicators showing color-coded capacity per person
Available in Board View, Workspace View
Indicator modes Worklog + Workload, Remaining Estimate, Availability, Original Estimate, Number of Items
Display Hours (h) or Percentage (%)
Data sources Capacity schemes, holidays, leave, task hours

Overview

The workload overlay turns the Resource Scheduler into a capacity-aware planning tool. When you switch it on, every cell in the scheduler grid gets a color-coded indicator. At a glance you can see whether a team member is overloaded, at capacity, or has room for more work on any given day.

Capacity is the number of working hours a person is available per day, set by their work capacity scheme. Utilization is the share of that capacity consumed by scheduled work.

The overlay pulls together scheduled hours from tasks, available capacity from capacity schemes, public holidays from holiday schemes, and approved leave. The result is a single, real-time picture of how work is spread across the team.

Tip Open the workload overlay during sprint planning or resource meetings. It makes imbalances visible before they become bottlenecks.

Enabling Workload View

One click is all it takes. The workload layer appears on top of the existing task bars and disappears just as quickly.

Open the Resource Scheduler

Navigate to any board (Board View) or open the Workspace View.

Click the Workload toggle

In the scheduler toolbar at the top, click the Workload button to enable the overlay.

Review the indicators

Each cell now shows scheduled hours vs. capacity as a color-coded indicator. Hover over a cell for a detailed tooltip.

Color Legend

Colors tell you instantly how loaded a person is. Blue and green mean things are fine. Yellow signals that a person is approaching their limit. Red means they are over capacity and need relief.

Color Utilization Range Meaning
Light Blue 0% – 50% Underloaded — plenty of room for more work
Green 51% – 100% Healthy utilization — at or near capacity
Yellow / Orange 101% – 120% Near capacity — consider rebalancing soon
Red > 120% Overloaded — reassign or reschedule tasks
Blue N/A Vacation / Leave — approved time off, no tasks expected
Purple N/A Conflict — tasks are scheduled on a leave or holiday day
Orange N/A Holiday — public holiday from the assigned holiday scheme
Grey / Striped N/A Non-working day — weekend or zero-capacity day

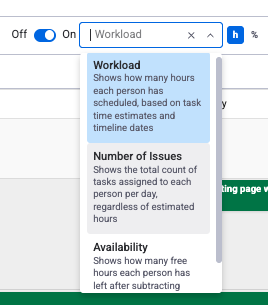

Indicator Modes

The overlay supports five indicator modes. Click the mode selector next to the Workload toggle to choose the view that fits your situation. Each mode shows a description to help you decide.

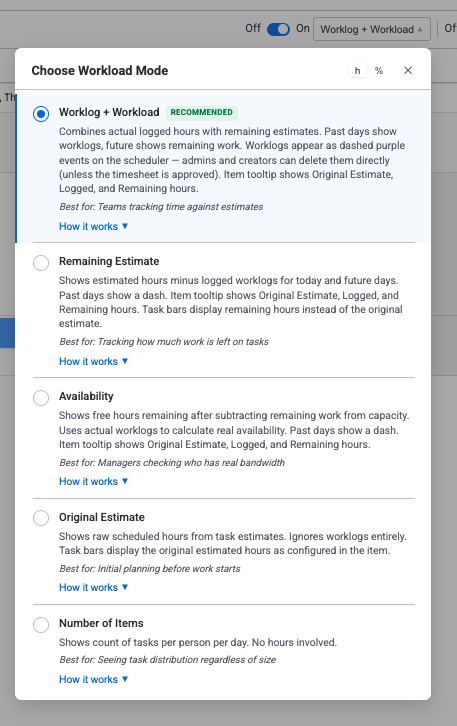

Workload mode selector showing all five modes
Mode What It Shows Best For
Worklog + Workload (default) Past days: actual logged worklogs. Today: worklogs + remaining estimate. Future: remaining estimate (Original Estimate minus logged hours). Teams that track time — shows real progress and what work remains
Remaining Estimate Past days: dash (–). Today + Future: remaining estimate only. Forward-looking planning — ignore past, focus on what is left
Availability Past days: dash (–). Today + Future: free hours (capacity minus remaining work). Can show negative when overloaded. Finding who has room for a new task right now
Original Estimate All days: scheduled hours from the estimate column, ignoring worklogs entirely. Classic workload view — pure plan without actuals
Number of Items Count of tasks per person per day. No hours involved. Spotting context-switching — many small tasks can be harder than few large ones
Tip Use Worklog + Workload as your daily default — it shows real logged hours in the past and remaining work in the future. Switch to Remaining Estimate for forward-looking planning, Availability when handing out ad-hoc tasks, Original Estimate for a pure plan view, and Number of Items to reduce context-switching.

How Remaining Estimate Works

In the Worklog + Workload, Remaining Estimate, and Availability modes, the workload indicator uses remaining estimates instead of raw planned hours:

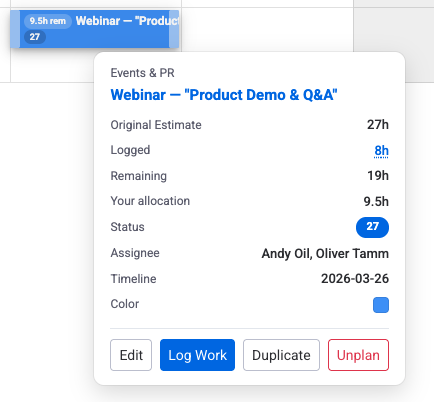

Tooltip showing Original Estimate, Logged, and Remaining hours

The item tooltip shows all the details: Original Estimate, Logged (clickable — opens the worklogs list), Remaining, and Your Allocation when the item has multiple assignees.

How Workload Is Calculated

The system computes a utilization percentage for every user on every day:

Utilization % = Workload Hours / Available Capacity × 100

Where Available Capacity is:

Available = Capacity (from scheme) − Holiday Hours − Leave Hours

Workload Hours depend on the active indicator mode:

For Original Estimate items (total format), remaining hours are calculated as:

Remaining = Original Estimate − Total Worklogs

Remaining hours are distributed across future working days only (from today onward), accounting for holidays, leaves, and capacity schedules. When per-person distribution is enabled, remaining hours are split equally among assignees. Hours Per Day items keep their constant daily rate — worklogs do not reduce per-day rates. See Original Estimate vs Hours Per Day for details.

Note If no capacity scheme is assigned, the system default (typically 8 h/day, Monday to Friday) is used.

Worked Example

Example — Overloaded Day

A team member has a standard 8 h/day scheme. On Monday three tasks are assigned:

  • Task A — 4 h
  • Task B — 2 h
  • Task C — 3 h

Total scheduled: 9 h / 8 h = 112.5% — shown as Yellow (near capacity, 101–120%).

Capacity with Holidays & Leave

Available capacity is not always the raw number from the scheme. Holidays and approved leave reduce it, and the workload indicator adjusts automatically.

Scenario Effect on Capacity Indicator
Regular working day Full capacity from scheme (e.g. 8 h) Normal color-coded cell
Public holiday Capacity = 0 h Orange
Full-day leave Capacity = 0 h Blue
Half-day leave (AM or PM) Capacity reduced by 50% (e.g. 8 h → 4 h) Normal indicator against reduced capacity
Weekend (0 h in scheme) Capacity = 0 h Grey / Striped
Warning Tasks scheduled on a holiday or full-day leave will push the indicator to purple (conflict) because capacity is zero but scheduled hours are not. Reassign or reschedule those tasks.
Example — Half-Day Leave

A team member with 8 h/day capacity takes a half-day leave on Wednesday. Available capacity drops to 4 h. With 3 h of scheduled work, utilization is 3 / 4 = 75%Green. With 5 h it would be 5 / 4 = 125%Red.

Display Modes

Choose how values appear inside the cells. Toggle between the two modes in the scheduler toolbar.

Mode Format Best For
Hours (h) 2.5 per day, with a weekly total in the header Exact daily planning and knowing how many hours are free
Percentage (%) 62% Quick visual scan of utilization across the week or month
Note The color coding stays the same in both modes. Only the label inside the cell changes.

Per-Person Distribution

When a task has more than one assignee, you need to decide how the hours are counted. The per-person distribution setting controls this.

Setting Behavior Example
Enabled (split hours) Hours are divided equally among assignees 8 h task with 2 assignees → 4 h each
Disabled (full hours) Each assignee is charged the full hours 8 h task with 2 assignees → 8 h each
Tip Enable splitting when your team collaborates and shares the work. Disable it when each assignee works independently for the full estimate (for example, reviewers or approvers).

Practical Tips

During Sprint Planning

Fixing Overloaded Days

Stay on Top of Changes

Check the workload view at least once a week. New tasks, shifting priorities, and late leave requests can turn a balanced Monday into a red Wednesday.

Combine with Other Features

Related Pages

Need Help?

Questions about workload management or capacity setup? Our support team is ready to help.

Contact Support
