What Are Capacity Schemes Back to top

When would I use this? Use capacity schemes when not everyone works the same hours. Examples: part-time staff, contractors, a four-day week, or weekend support. If everybody works 8 hours Monday to Friday, you do not need to change anything.

A capacity scheme is a weekly schedule. It says how many hours a person works on each day, from Monday to Sunday. A day with 0 hours is a day off. These hours are the person's capacity.

The app uses capacity to:

  • show how busy each person is in the Scheduler (planned hours compared with available hours);
  • colour the workload bars blue, green, orange or red;
  • work out the required hours in timesheets and reports.

Holidays and approved leave are taken off on top of the scheme.

You manage schemes in Settings → Capacity. The tab has two parts: the Capacity Schemes list on top and the Assignments table below it.

Settings → Capacity. Each scheme shows its hours per weekday and how many people use it. Demo data.

Who can do what

Action Admin Everyone else
Create, edit, duplicate or delete a scheme Yes No
Assign a scheme to a person or a team Yes No
See your own scheme in My Account Yes Yes

An admin is a monday.com admin or an App Admin. Team Managers cannot change schemes or assignments.

Default Scheme Back to top

The default scheme is the one used by everyone who has no scheme of their own and no team scheme. It carries a green Default badge in the list.

A new account starts with one scheme, Standard Full-Time, already set as the default: 8 hours Monday to Friday, Saturday and Sunday off. That is 40 hours a week.

  • You can edit the default scheme. The change applies to everyone who uses it.
  • You cannot delete the default scheme. Set another scheme as default first.
  • Only one scheme can be the default. Turning on Set as Default in another scheme moves the badge to it.
  • If no scheme is the default, people without an assignment are counted as 8 hours Monday to Friday.
Common mistake

Editing the default scheme when only a few people need different hours. Lowering the default from 8 to 6 hours lowers capacity for everyone on it. Create a separate scheme for those few people instead.

Creating a Scheme Back to top

  1. Go to Settings → Capacity.
  2. Click Create New. The Create Capacity Scheme dialog opens.
  3. Type a name, for example "Part-Time 4h". The name can be up to 100 characters.
  4. Under Weekly Schedule (hours per day), type the hours for each day, from 0 to 24. Type 0 for a day off. The line below shows the average per working day and the weekly total.
  5. Optional: turn on Set as Default.
  6. Optional: under Assigned Users and Teams, pick the people or teams who should use this scheme.
  7. Click Create Scheme. The people and teams you picked are assigned at the same moment.

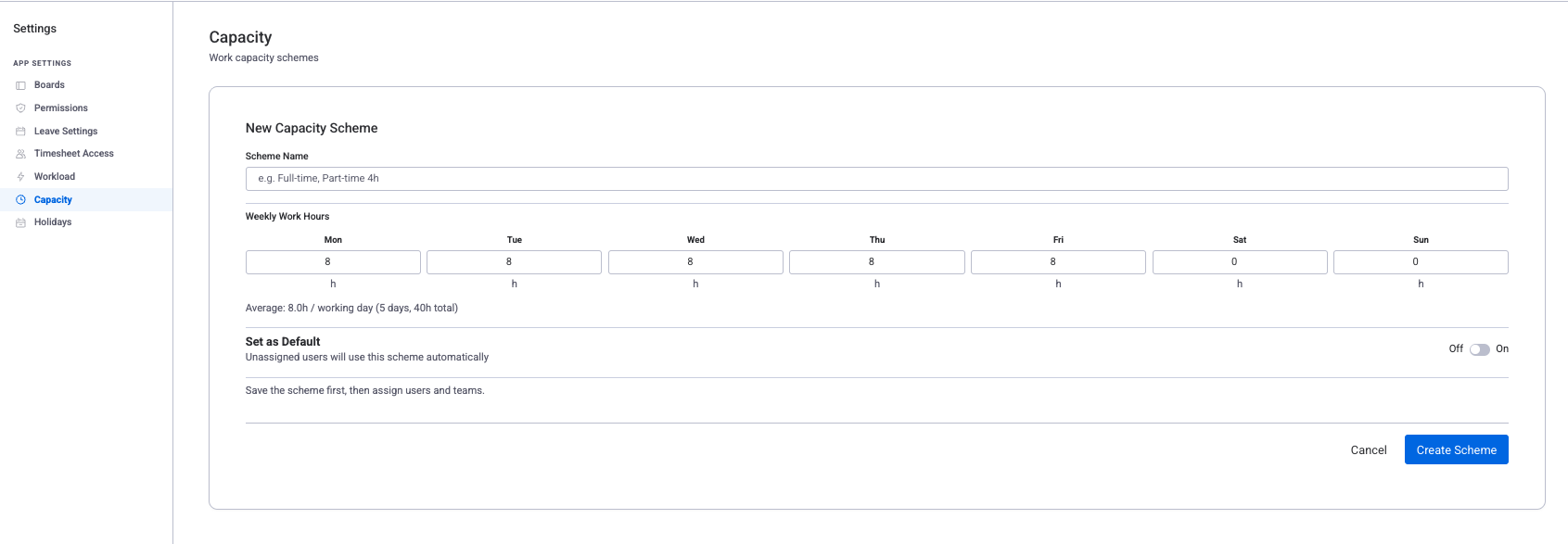

Create Capacity Scheme dialog: scheme name, weekly schedule with hours per day, an average line, Set as Default, and Assigned Users and Teams with a User or Team toggle and a picked person

Example schemes

Scheme Mon Tue Wed Thu Fri Sat Sun Total
Part-time 4h4h4h4h4h0h0h 20h a week
Four-day week 10h10h10h10h0h0h0h 40h a week
Weekend support 0h0h0h0h0h8h8h 16h a week

Managing Schemes Back to top

Each scheme in the list shows its name, a summary such as "8h/day · 5 days/week · 3 user(s)", and the hours for each weekday. Three actions sit next to it.

Action What it does Good to know
Edit Change the name, the hours, the default setting or who uses the scheme. Click Save to keep changes to the name and hours. They then apply to everyone on the scheme.
Duplicate Makes a copy called "name (Copy)" with the same hours. The copy has nobody assigned and is never the default.
Delete Removes the scheme and all its assignments. This cannot be undone. Not available for the default scheme.
Before you delete a scheme

People who used the deleted scheme fall back to their team's scheme, or to the default scheme. Their available hours change straight away, so check the Scheduler afterwards.

Assigning Schemes to Users Back to top

An assignment links a person or a monday.com team to a scheme. Each person has one scheme at a time, and so does each team.

Which scheme a person gets

  1. Personal assignment — a scheme assigned to the person always wins.
  2. Team assignment — if the person has none, the scheme of their team is used. If several of their teams have a scheme, the team that was assigned first wins.
  3. Default scheme — everyone else.

A team assignment covers everyone who is in the team in monday.com. People who join or leave the team are picked up without any change in the app. Use a personal assignment for the one person in a team who works different hours.

Assign from the Assignments table

  1. In the Assignments section, click Add Assignment.
  2. Under Users and Teams, pick one or more people or teams. Use the User / Team toggle to switch between them.
  3. Under Capacity Scheme, pick the scheme.
  4. Save.
Add Assignment dialog: a User or Team toggle, a search field where several users can be picked, and a Capacity Scheme select

In the table you can also:

  • click Edit on a row to move that person or team to another scheme;
  • click Delete on a row to remove the assignment;
  • use Filter by user to find one person's assignment.

Assign from inside a scheme

Click Edit on a scheme and add or remove people and teams under Assigned Users and Teams. On an existing scheme, each change applies at once.

Moving and removing: If you assign a person or team that already has a scheme, they move to the new one. If you remove a personal assignment, the person falls back to their team's scheme, or to the default.
Best practice

Group people by how they work. Put all part-time staff on a "Part-Time" scheme and everyone on a four-day week on a "Four-day week" scheme. You then change the hours in one place.

Each person can see their own scheme, and where it comes from, on the My Account page.

How Capacity Feeds into Workload Back to top

Workload compares the hours planned for a person with the hours they have available.

  • Available hours come from the capacity scheme, minus holidays and approved leave.
  • Planned hours come from the items assigned to the person.
  • Utilization is planned hours divided by available hours, shown as a percentage.
Utilization Colour Meaning
Up to 50% Light blue Room for more work
51% – 100% Green Well used
101% – 120% Orange Slightly over — consider moving work
Over 120% Red Overloaded
Holidays and leave: A holiday or a full day of approved leave gives the person 0 available hours that day. Half a day of leave halves them. Leave taken in hours removes that many hours. See Workload Management for details.
Workload looks wrong?

First check which scheme the person has. Use Filter by user in the Assignments table. A wrong scheme is the most common reason for odd numbers.
