Each use case below starts with a problem, lists what you use, and then gives the steps. Two terms come up often:
- Capacity — the hours a person can work on a day.
- Workload — the hours of work planned for that person on that day. The scheduler colours each day by workload against capacity: blue is light, green is fine, orange is slightly over, red is overloaded.
1. Catch Slipping Work Before It’s Too Late Back to top
The Problem
A developer has a 40-hour task from Monday to Friday. On Monday morning the plan looks fine: 8 hours a day against 8 hours of capacity. Then an urgent bug takes the whole Monday. A fixed plan would still show 8 hours a day, and nobody would notice the problem until Friday.
What You Need
- Time Tracking switched on.
- The Live workload basis in Settings > Workload.
- The Workload toggle on in the scheduler, with the Remaining Estimate mode. It shows the work that is still left: the estimate minus the time already logged, spread from today to the item's end date.
What Happens
- Monday morning: 40 hours, 5 working days. The scheduler shows 8h/day.
- Monday, end of day: the developer logs nothing on the task.
- Tuesday: 40 hours are still left, but only 4 working days remain. That is 10h/day against 8 hours of capacity. The days turn Red. The manager sees the overload on Tuesday.
The manager asks the developer:
- “Did you work on it and forget to log?” The developer logs the hours. Less work is left, and the days return to Green.
- “No, I was on the bug.” The work is really behind. The manager moves the end date, or gives part of the task to someone with free hours.
Why This Matters
Every hour that is logged, or not logged, changes how much work is left for the coming days. Problems show on day 2, not on day 5.
Features Used
- Remaining Estimate mode — see Workload modes.
- Item details — click an item on the scheduler to see Original Estimate, Logged and Remaining.
- Over-logged items — an item with more time logged than estimated gets a red dashed border.
- Mobile time tracking — people can log from their phone, so the plan stays current. See Mobile Time Tracking.
2. Find Who Has Time for Urgent Work Back to top
The Problem
It is Wednesday. An urgent task comes in. You need to know who really has time for it. The original plan does not help: some people finished early, others are behind.
Step-by-Step
- In the scheduler, turn on Workload and choose the Availability mode.
- Each day now shows free hours: capacity minus the work that is still left. People who logged their work and finished early show more free hours.
- Look for the person with the most free hours on the days you need.
- Assign the urgent task to that person. The numbers update at once.
Why This Matters
The original plan would show everyone as fully booked, even if half their work is done. Availability shows who can take more work now.
3. Check Logged Hours Before You Invoice a Client Back to top
The Problem
At the end of the month you invoice a client for the hours worked on their project. You are not sure that everyone logged their time, or that the logged hours make sense against the plan.
Step-by-Step
- Open the scheduler with the client's board, in Remaining Estimate mode.
- Click an item. Its details show Original Estimate, Logged and Remaining.
- Look for items with a red dashed border. More time was logged on them than estimated. You may need to discuss them with the client.
- Click the Logged value to open the Worklogs list: every entry with its hours, date and person.
- Go to Reports and open Work Log Audit Trail. Choose the period, set Group by to Board, and click Create.
- Click Export Excel and use the client's board section for the invoice.
Why This Matters
You check the hours against the plan before the invoice goes out. Over-logged items show scope creep early, before it becomes a billing dispute.
4. Balance Team Workload Across Projects Back to top
The Problem
Your team works on several projects at once. You cannot easily see who has too much work and who has room for more. One person has 10 hours of tasks on an 8-hour day while another is half busy.
Features Used
- Resource Scheduler — a timeline of items, one row per person.
- Workload — a coloured bar per day that shows how full each person is.
- Several boards in one scheduler — see everyone across all projects.
- Capacity & Utilization Overview report — each person's planned hours as a percentage of the hours they can work (their utilization).
Step-by-Step
- Open the Scheduler and add all your project boards with Add boards.
- Turn on the Workload toggle. Choose Remaining Estimate if your team logs time, or Original Estimate if it only estimates.
- Look for Red days. The person has more than 120% of their capacity planned.
- Drag a task from the overloaded person's row to the row of someone whose days are blue or Green. The item is reassigned and the bars update.
- Go to Reports and run Capacity & Utilization Overview. Check each person's Utilization Rate.
Result
You see each person's daily load at a glance and can repeat the check whenever new tasks come in. Many teams aim for 85–95% utilization: busy, with a little room for the unexpected.
Use the colours as a quick daily check: blue is up to 50% of capacity, green is up to 100%, orange is up to 120%, red is more.
5. Track Time and Bill Clients Accurately Back to top
The Problem
You bill clients by the hour. But people forget to log time, or type rough numbers at the end of the week. You end up billing too little or too much, and you cannot give the client a clean list.
Features Used
- Time Tracking — log time by hand or with a timer. Each entry is a worklog.
- Worklog categories — mark time as Billable (you can charge for it) or Non-Billable.
- Work Log Audit Trail report — every worklog in a period, with Excel export.
Step-by-Step
- During the day, open Time Tracking, click Start timer, pick the item and click Start. Click Stop when you finish and confirm the worklog.
- To log afterwards, click + Worklog, search for the item, enter the time, pick the category and click Submit.
- From the scheduler, click an item and then Log work.
- On the go, log from the item's Time Tracking tab in the monday.com mobile app. See Mobile Time Tracking.
- At the end of the billing period, go to Reports and open Work Log Audit Trail.
- Choose the Period, optionally the People, and set Group by to Board. Click Create.
- Check the rows. Each one shows the person, date, board, item, category, hours and comment.
- Click Export Excel and attach the file to the invoice.
Result
You have a list of every hour spent on the project, by item, person and date, with billable time marked. Clients see what they pay for.
- Ask the team to use the timer when they can. It is more exact than typing hours at the end of the week.
- For billable and non-billable totals per person, use the Logged Time report in Timesheets.
6. Set Up Timesheet Approval for Your Team Back to top
The Problem
Your team logs time, but nobody checks it before it goes to payroll or to a client. Mistakes slip through: hours on a weekend, double entries, time on the wrong item. You want a review step.
Features Used
- Timesheet approval — each person sends the period's worklogs (their timesheet) to an approver, who accepts or rejects it.
- Submission Status — shows who has not submitted yet.
- Work Log Audit Trail report — worklogs with their approval status, for payroll.
Step-by-Step
Part A: An admin switches it on
- Open Settings > Timesheet Config and turn on Approval Workflow. Choose the Submission Period: Weekly, Biweekly or Monthly.
- Open Settings > Timesheet Access. On the Approvers tab, click Add Rule to give a team or all users an approver.
Part B: Team members submit

- Each person opens Time Tracking and shows the full period, for example Last week.
- They check their worklogs and fix mistakes.
- They click Submit for Approval and confirm. The timesheet shows Pending Approval.
Part C: The approver reviews
- Open Timesheets > Approvals > Pending Approvals.
- Click a timesheet to see its worklogs per day. Look for anything unusual, such as hours on a weekend.
- Click Approve. Or click Reject and type what to fix. The person sees the reason in Time Tracking, corrects the worklogs and clicks Resubmit for Approval.
- Open Submission Status to see who has not submitted for the period.
Part D: Export the hours for payroll
- Go to Reports and open Work Log Audit Trail.
- Set the Period to the pay period and click Create.
- Click the Status column header to sort. Approved worklogs show Closed Approved, with the approver in Approved by.
- Click Export Excel and hand the file to payroll or finance.
Result
Every worklog is reviewed before it reaches payroll. You also have a record of who approved what.
Approvers can tick several timesheets and click Approve selected to approve them in one go. See Timesheet Approval.
7. Get a Cross-Project Overview for Leadership Back to top
The Problem
You manage several project boards across teams. Before a quarterly review you spend hours collecting numbers from each board. You want one place that shows where everyone is booked, and a file you can present.
Features Used
- Scheduler with several boards — everyone across all projects in one timeline.
- Capacity & Utilization Overview report — planned hours as a percentage of available hours, per person.
- Time-Off & Absence Summary report — approved leave per person.
- Excel export — for charts and presentations.
Step-by-Step
- Open the Scheduler and add the project boards you want to watch with Add boards.
- Turn on the Workload toggle. Red days show who is overbooked across all boards together.
- Go to Reports and run Capacity & Utilization Overview. Leave Boards empty to include all boards. Look for people who are far above 100% or far below it.
- Run Time-Off & Absence Summary for the coming months. Note leave that falls on important milestones.
- Click Export Excel on each report and build your charts from the files.
- Click Bookmark on each report, so next quarter it takes one click.
Result
One view of where people are booked across the organization, and report files based on real numbers for staffing decisions.
8. Manage Holidays, Leave and Capacity for Distributed Teams Back to top
The Problem
Your team sits in several countries with different public holidays. You plan a sprint and forget that half the team is off for a regional holiday. Leave requests arrive by chat or email, with no single record. You want holidays and leave to be counted in the plan automatically.
Features Used
- Holiday calendars — public holidays per region. A holiday leaves no available hours that day.
- Leave — people request time off; with approval on, an approver accepts or rejects it.
- Capacity schemes — the working hours per weekday for each person, for example 8 hours full-time or 6 hours part-time.
- Time-Off & Absence Summary report — leave days per person and leave type.
Step-by-Step

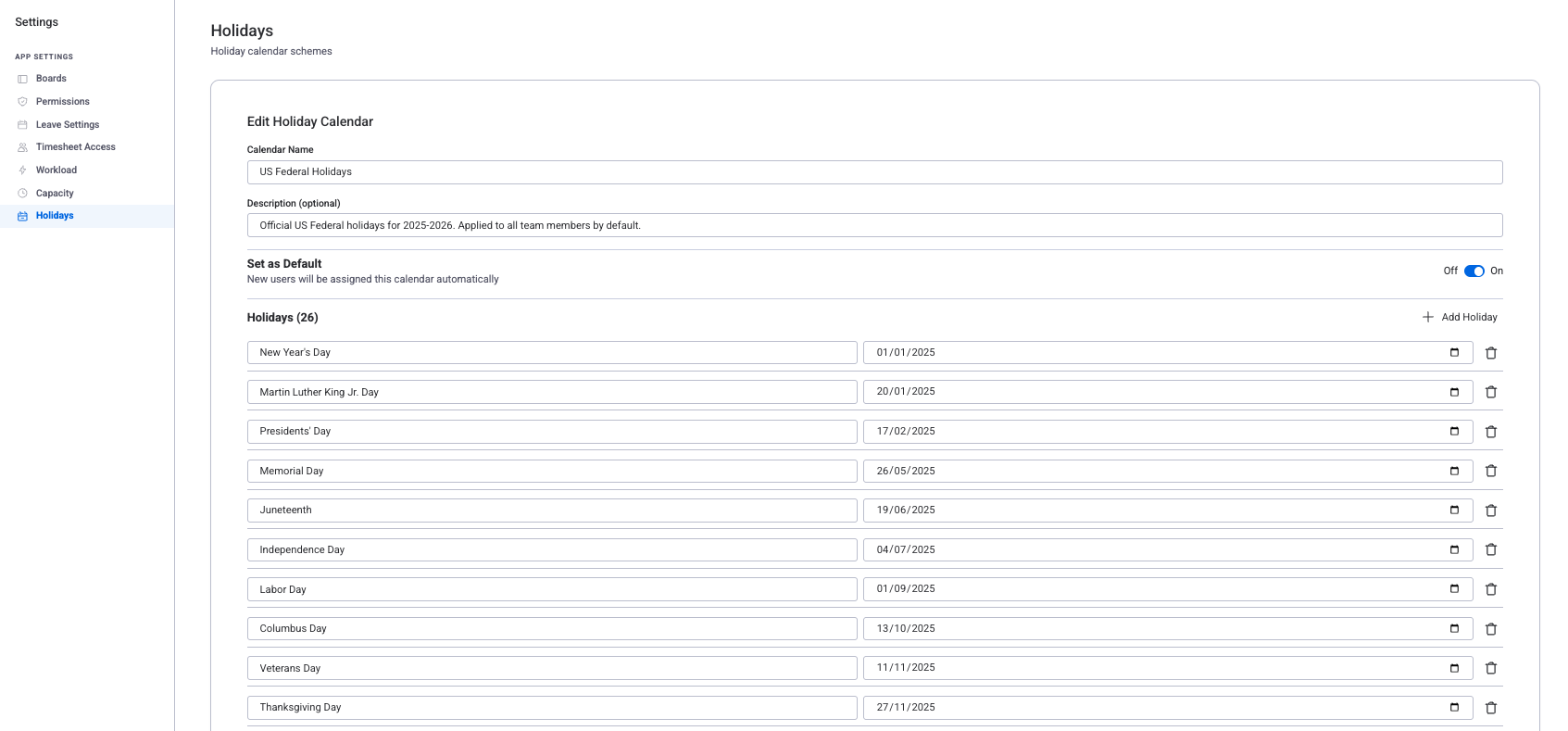

Step 1: Set up a holiday calendar per region
- Open Settings > Holidays and click Create New.
- Name the calendar after the region, for example "Germany Holidays".
- Click Import public holidays, choose the country and the year, and add the holidays.
- Click Add Holiday for company days off.
- Assign the people or teams in that region to the calendar. Or set one calendar as the default for everyone.
- Repeat for each region.
See Holiday Schemes.
Step 2: Set up leave
- Go to Settings > Leave Settings. Under Leave Types, keep Vacation, Sick Leave and Personal Day, or click Add Type for your own.
- Turn on Allow partial days for types where people may take a few hours off.
- Under Leave Workflow, turn on Require approval for leave if requests should wait for an approver. Then set each person's approver under Leave Approvers.
Step 3: Handle leave requests
- People go to Leave > My Leaves, click Request Leave, choose a leave type and the dates, and click Submit.
- With approval off, the leave counts at once. With approval on, the approver opens Leave > Approvals.
- Before deciding, check the scheduler for deadlines and for others who are off on those dates.
- Click Approve or Reject. Approved leave lowers the person's available hours on those days.
Step 4: Set working hours for part-time people
- Go to Settings > Capacity and click Create New.
- Type the hours for each weekday, for example 6 hours Monday to Friday for a part-time scheme.
- Assign people or teams to the scheme, in the same dialog or later with Add Assignment.
Result
The scheduler now counts regional holidays, approved leave and each person's own working hours. When you plan, you see the hours each person really has. Leave is recorded in one place, and the Time-Off & Absence Summary shows the days each person took, by leave type.
Run the Time-Off & Absence Summary before you plan a sprint. If several people are off in the same week, the hours you can plan drop sharply.
