Overview Back to top

Workload indicators add a small colored bar under each person for every day on the Scheduler. Each bar compares the work scheduled for that day with the hours the person is available, after holidays and approved leave are taken off.

Workload indicators under each person on the Resource Scheduler

Each person's row also shows a total for the period on screen. In the Year - Monthly view, there is one bar per month instead of one per day.

Turning Workload On Back to top

Use the workload On / Off switch in the Scheduler toolbar to show or hide the indicators. The dropdown next to it opens Choose Workload Mode, where you pick what the bars show (see View modes) and whether numbers appear in hours (h) or as a percentage (%).

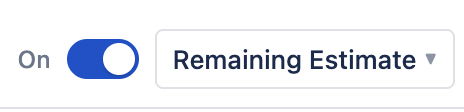

Workload switch in the scheduler toolbar

What the Colors Mean Back to top

The percentage is scheduled hours divided by available hours for that day.

Color Meaning
Light blue Under 50% — plenty of free time
Yellow-green 50–79% — partly loaded, room for more
Green 80–100% — well loaded, the healthy target
Orange 101–120% — slightly overbooked
Red Over 120% — overbooked, needs action
Blue On approved leave
Deep orange Public holiday
Red with ⚠ Conflict — work is scheduled on a leave or holiday day
Light grey No work scheduled (non-working days have no bar)

Workload Basis: Live or Planned Back to top

An admin chooses the Workload basis for the whole site in Settings → General. It drives the Scheduler and the forecast reports.

  • Live workload (default) — shows the work still left on each issue (Jira's remaining estimate), from today onward. It shrinks as people log time. Best if your team logs work in Jira.
  • Planned workload — spreads each issue's estimate over all of its dates, past days included. Best if your team rarely logs work or estimates in story points. The admin also picks the Estimate source: Original estimate (default) or Remaining estimate.

By default, issues that are already done still count if they have hours left. An admin can switch Resolved issues to Exclude resolved issues to leave them out.

View Modes Back to top

In Choose Workload Mode, each person picks how their own Scheduler shows workload. This changes only your view; reports always follow the site's Workload basis.

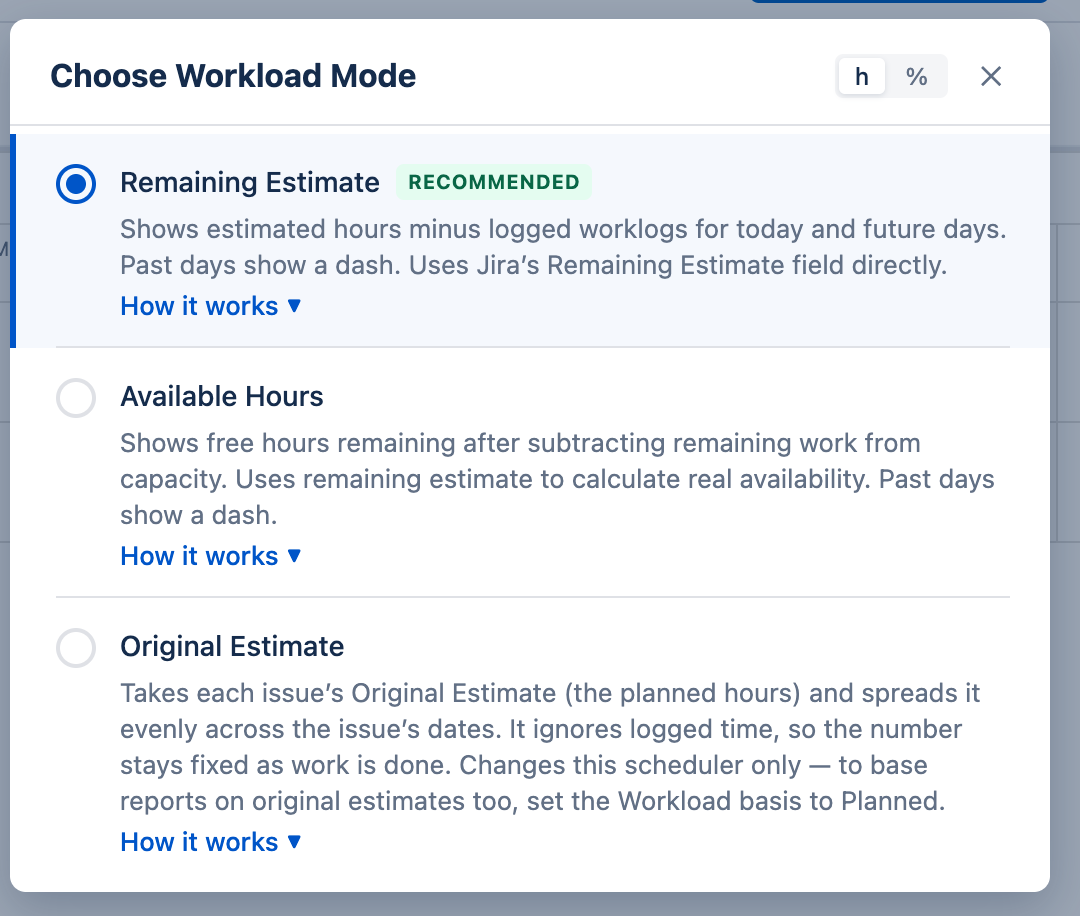

Choose Workload Mode dialog under the Live basis
Basis Modes you can pick
Live Remaining Estimate (work left, from today), Availability (free hours left), or Original Estimate (the planned hours spread over the issue's dates).
Planned Workload (planned hours) or Availability (free hours left).

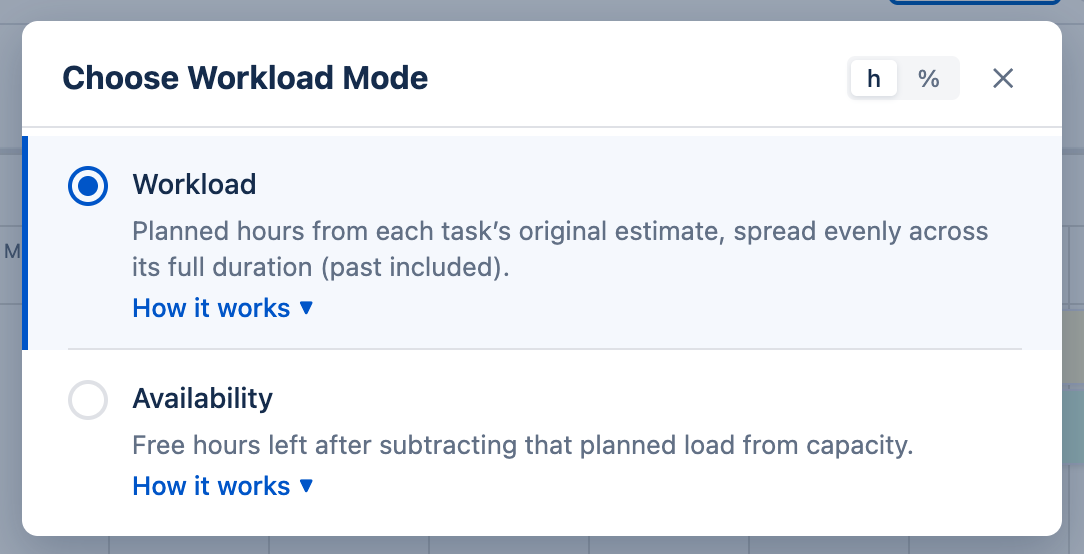

Choose Workload Mode dialog under the Planned basis with Workload and Availability

How Workload Is Calculated Back to top

An issue's hours are spread evenly over the working days between its start and end dates. For example, 16 hours over 2 days shows as 8 hours a day. Allocations add their hours per day. Issues with no estimate add nothing.

Available hours come from the person's capacity scheme, minus holidays and approved leave. With 8 available hours, 6 scheduled hours is 75% (yellow-green), and 10 hours is 125% (red).

Leave and holidays lowering capacity in the workload indicators

Planning with Story Points Back to top

If your team estimates in story points, an admin can turn them into hours in Settings → General → Story Point Conversion (for example, 1 story point = 5 hours). Projects can use their own rate in Per Project Configuration. Story points never go down as work is logged, so use them with the Planned workload basis.

Split Issues Back to top

For a split issue, each person's workload counts only their own part.

  • Total hours — a budget spread over the part's working days (10h over 5 days = 2h a day). Time logged through WorkHub reduces what is left.
  • Hours per day — the same hours on every working day of the part, such as a daily support shift. It keeps counting even after the issue is done.

Day Details Back to top

Click any workload bar to see that day's Scheduled, Free and Capacity hours. On a leave or holiday day it also shows the hours taken off, and a Work scheduled on leave/holiday warning if something is planned that day. Click a person's period total to see the same breakdown for the whole period.

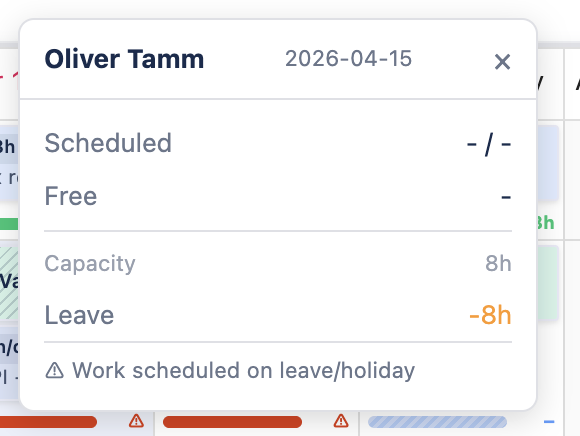

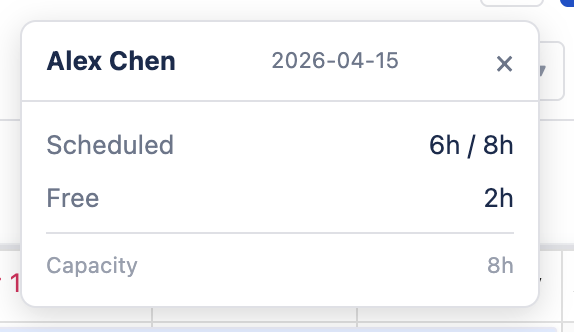

Day details on a regular working day Day details on a leave day with a conflict warning

Tips Back to top

  • To fix a red day, drag an issue to another day, or drag it to another person's row to reassign it.
  • Use Availability mode to see exactly how many free hours each person has.
  • Keep estimates up to date in Jira — the bars are only as accurate as the estimates behind them.
  • For longer periods, use the Resource Utilization Forecast report.
